Breakdown 5 of 5
Producing a team of 11
I produced the 11-person team behind Borderline Racing, running the weekly SCRUMs, the schedule, playtest feedback and every build of the game.
Overview
As producer I planned the schedule, ran the weekly SCRUMs and turned the feedback from each playtest into tasks. I also kept the project organised in Perforce and in-engine, and made and debugged every build of the game. Creative decisions were made as a team, and a large part of my job was thinking those decisions through, sorting out technical problems and keeping everyone coordinated. I often was the glue, jumping between sections of development and making sure everyone’s work worked together.
Planning the project

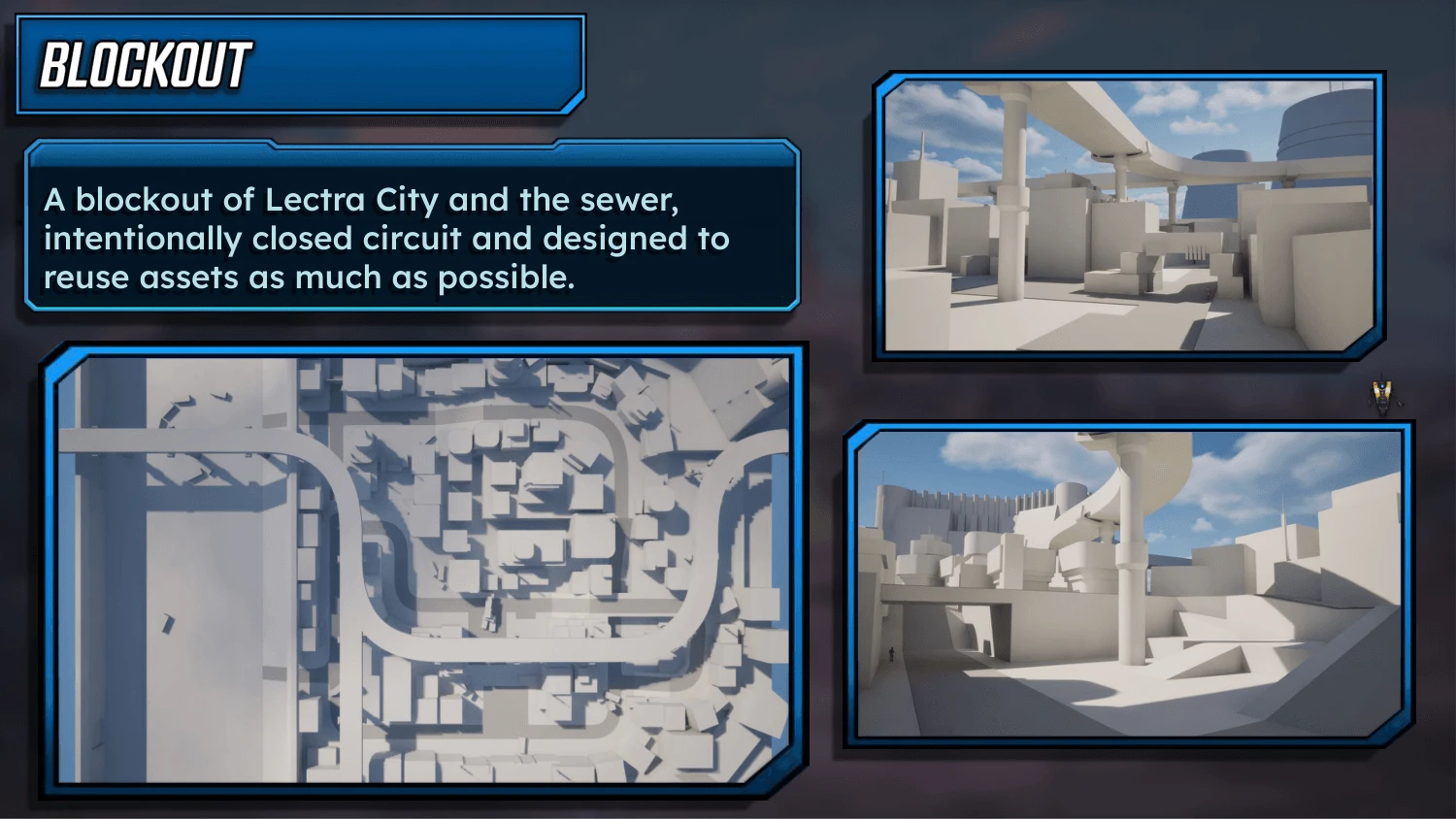

We planned the project around getting something playable as early as possible and iterating on it, with feedback driving the decisions. The most important art and gameplay came first and everything else was built up in layers. For me that meant a gameplay MVP and master materials, the first artist tools, only then later optimisation and VFX, and a round of gameplay polish. The early gameplay work ran on a grey blockout of the city, and I wrote the Blockout slide of the art bible.

First I organised people into the roles they wanted to fill. When people knew the area they would need to cover, it was easier to see a final goal of how many assets they would make. This, along with the asset list I drove, let us quickly understand what would be necessary.
The schedule

The production timeline was a Trello board with a column for each week. Every card was tagged by discipline and had a priority and a status, and the deadlines sat on the board as deliverables. When I planned the scope at the start I built in buffer time, which gave us room when problems came up and meant anyone who needed a break could take one.

Towards the end the board got crowded and we were rushing through assets, so for the final two-week sprint we switched to one big to-do list on screen for everyone, showing what needed doing and by whom. It suited the pace at the end, when several assets were being finished each day, and also worked as a motivator for reaching the end.
SCRUM and feedback
Every Tuesday I ran a SCRUM to go over what had been done and what was next. Most problems left the meeting with a plan of action, and every member had a say in the decisions. As the project went on, we also decided together in these meetings what to cut and how to share out the remaining work, and a few extension tasks didn’t make it into the final game. This was really important to keeping our scale consistent with the timeframe and meant we all understood collectively what was and wasn’t realistic.
After each playtest and the industry feedback session, I compiled the feedback and worked it into the following weeks alongside what was already planned. Vehicle physics, the track borders and the layout were all brought forward or added as tasks this way, and the biggest change was to the driving, which is covered on the gameplay page.
Keeping it organised

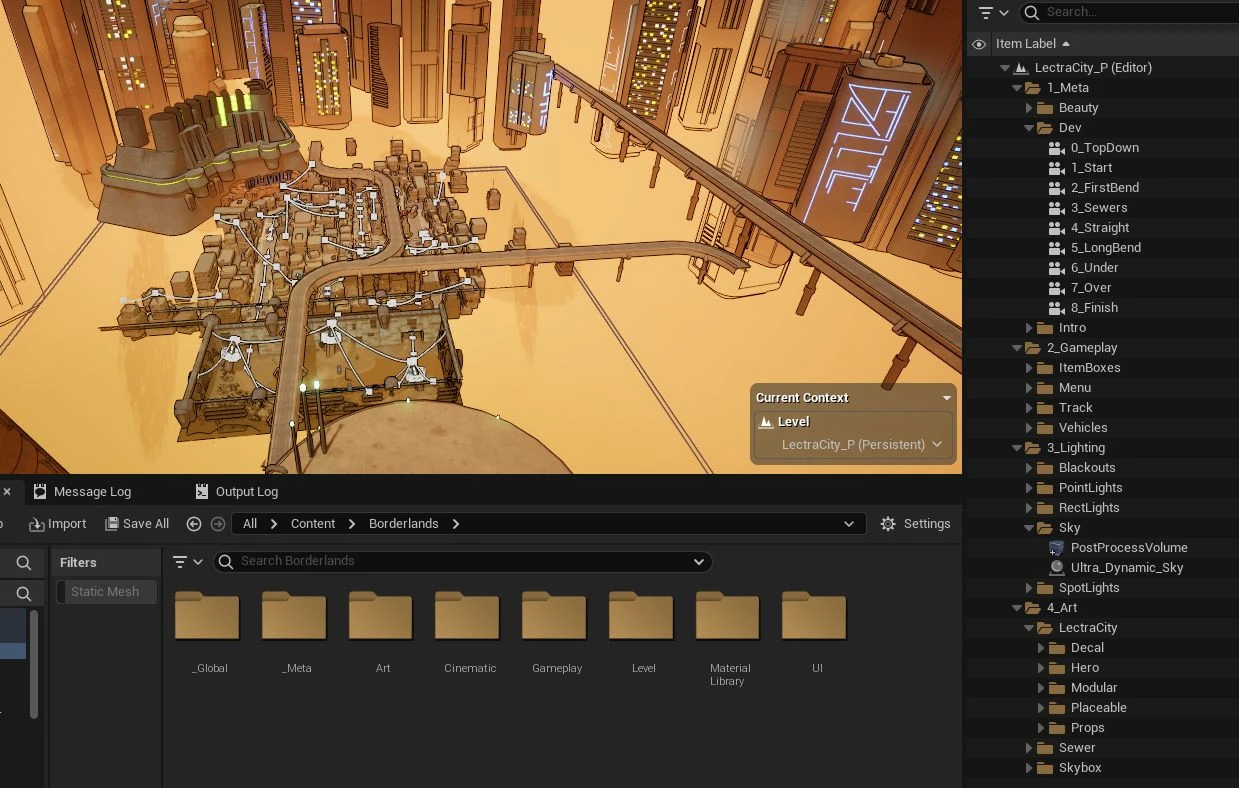

I kept the folders, outliner and levels organised the whole way through, and held everyone’s files to the naming conventions in our style guide. The project lived in Perforce, and I kept the depot tidy as well.

The level is split into sub-levels, with the art ones (ground, props and structures) kept separate from technical ones like audio, gameplay and lighting, so people could work on the same area without locking each other’s files.

Tracking progress
Development screenshots were one of our deliverables, so I set up 9 fixed cameras around the track and put them into a sequence so I could easily capture a snapshot of the game’s state. We avoided moving the cameras as much as possible, so continuity held up well across the weeks. The script was set up locally and run by hand, so I had to remember to activate it, and in busy weeks I sometimes forgot. I fixed this the next year with the Project UMBRAE development cameras.

12 Mar9 Apr18 MayThe top-down camera shows the whole city coming together, and at the end I cut the captures together into a development breakdown.
Reflections
The planning meant we didn’t have to scrap much of what we set out to do, and the buffer time absorbed the delays that came up without overloading anyone. The one thing I’d change is my own workload. On top of producing, I took on 3+ other roles, and it led to a small amount of burnout. It worked over 14 weeks, but it wouldn’t be sustainable on a longer project or in industry. The next team I produced was Project UMBRAE and I tried to avoid the multi-hat role as much as possible.
